Scrum

Waterfall v Scrum

Don’t use waterfall

Waterfall Sample Project

Waterfall Example

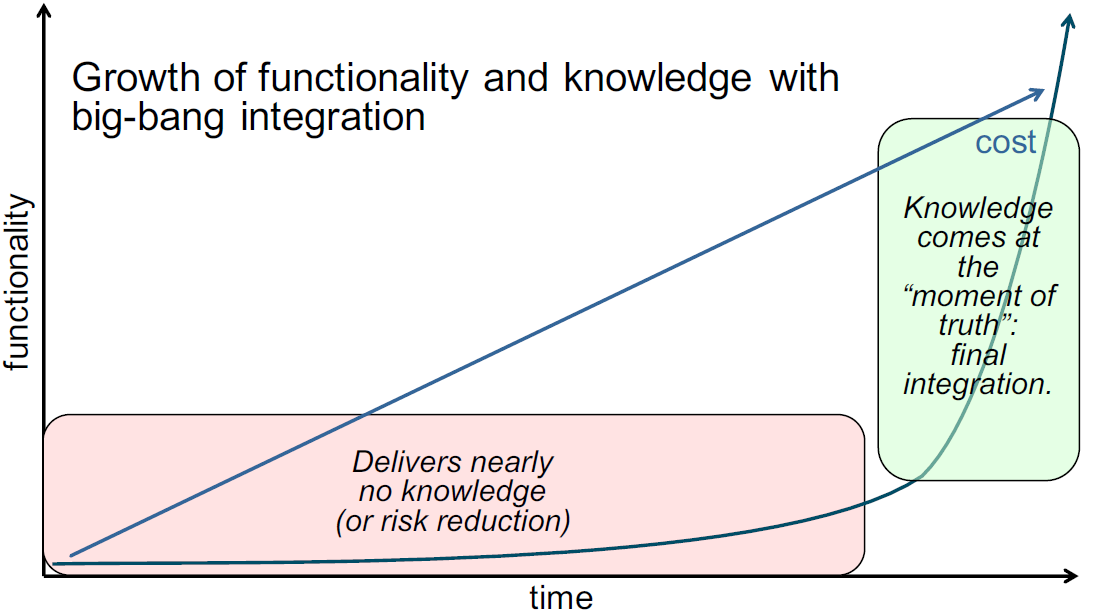

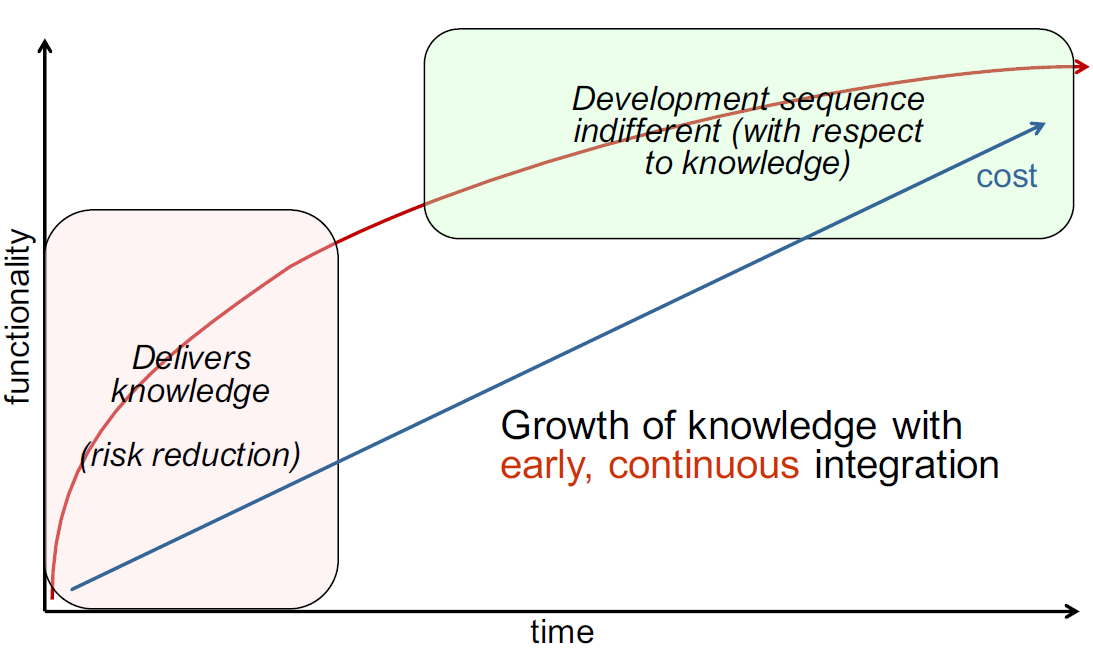

Waterfall Functionality of Project

Waterfall Example Functionality

Scrum Sample Project

Scrum Example

Scrum Functionality of Project Scrum Example Functionality

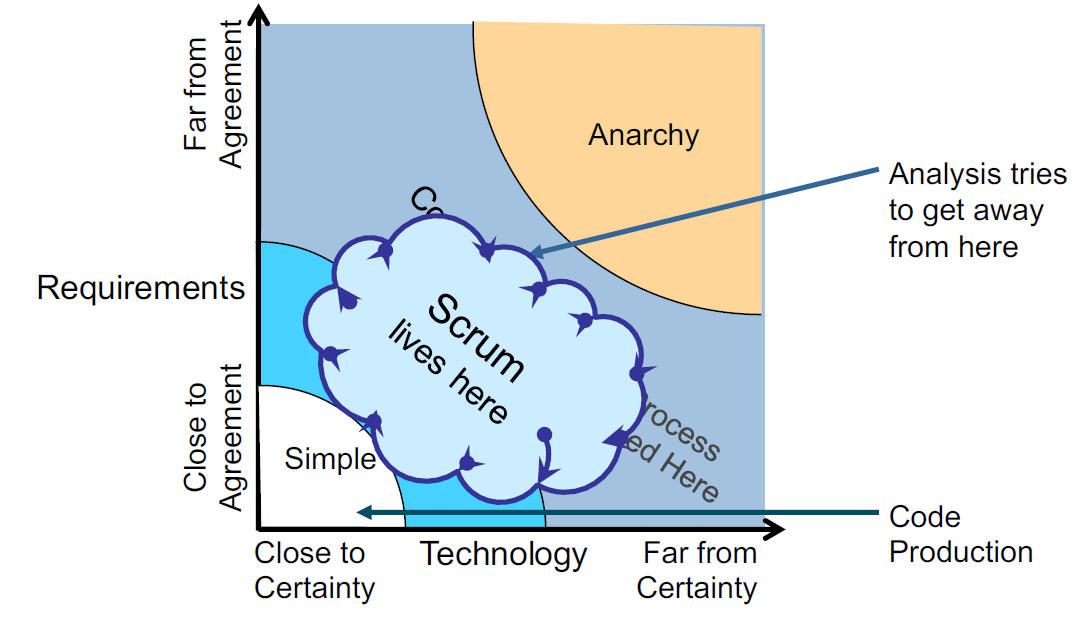

Scrum Outline

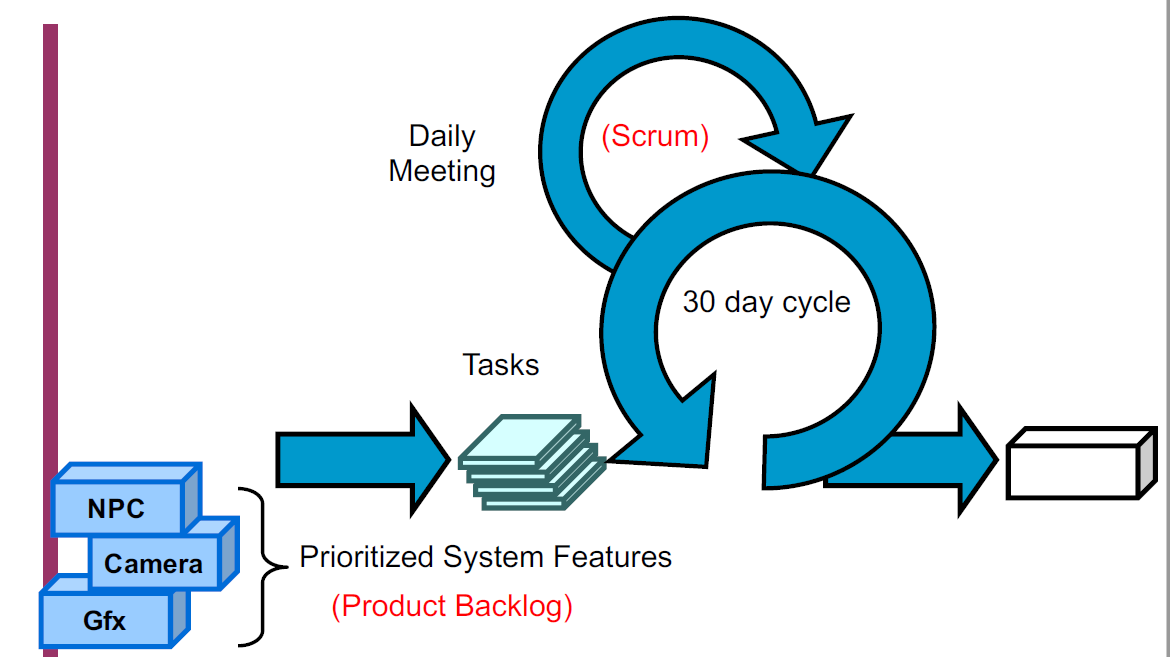

Scrum Skeleton

Scrum Skeleton

Sprints

Scrum Meetings

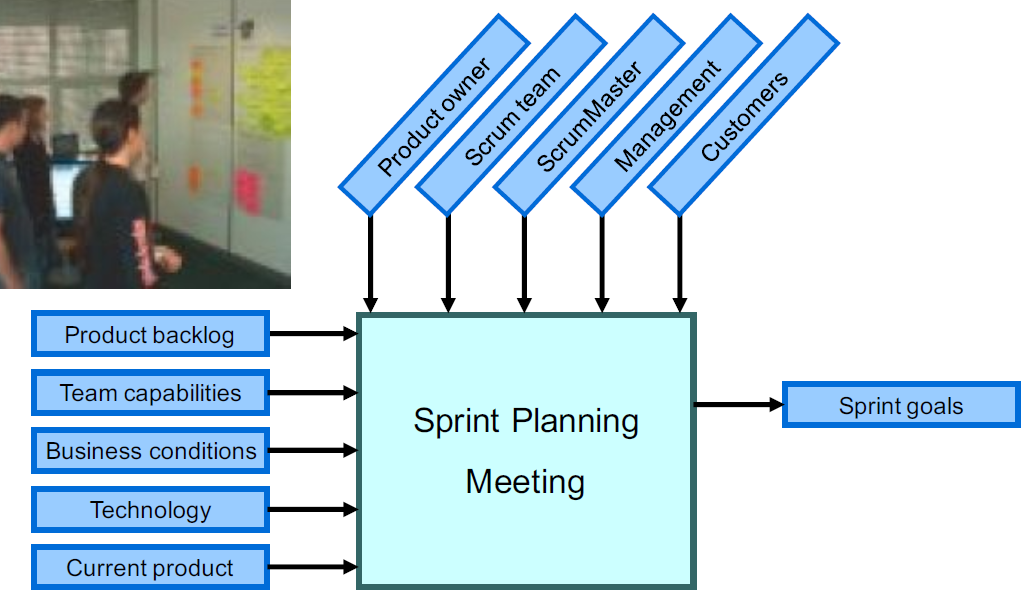

Sprint Planning

People planing for the 30 day sprint Who do we give them to, and how do we give them to people

Sprint Planning

Time Boxed

First Four Hours - Deciding what to do

Second four hours - planning the Sprint

Process Artefacts

Process Overview

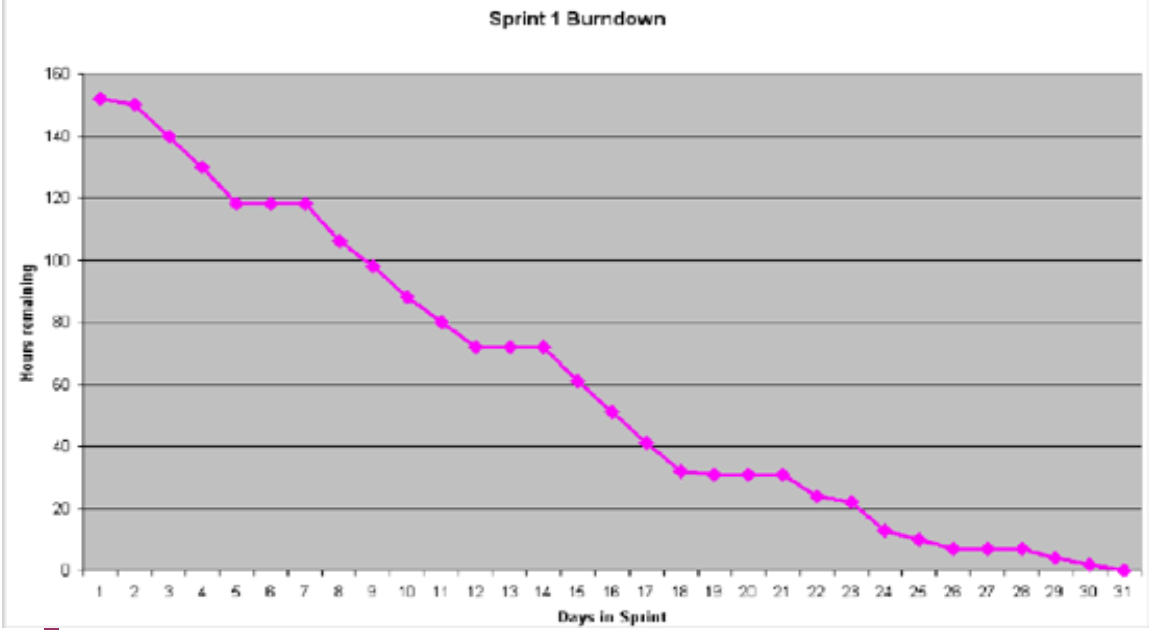

Burndown Chart

Scrum’s Artefacts

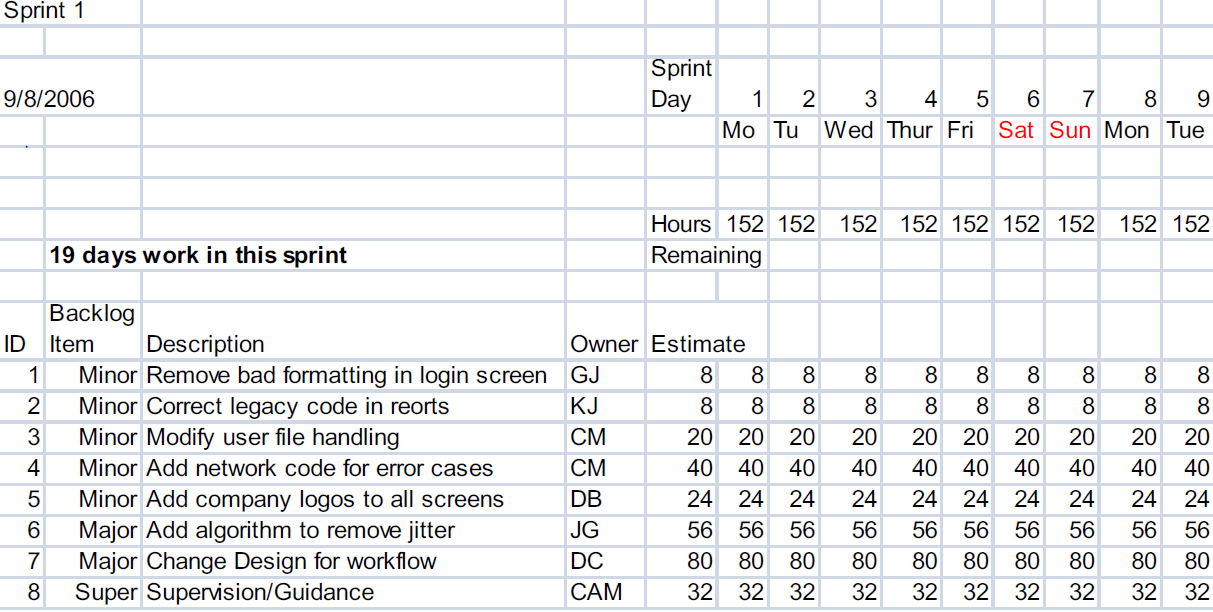

Backlog Example

Burndown Charts

Burn Down Beginning

Ideally it should look as follows:

Burn Down During

Although, if work is done too slowly it can look as follows:

Burn Down Slow

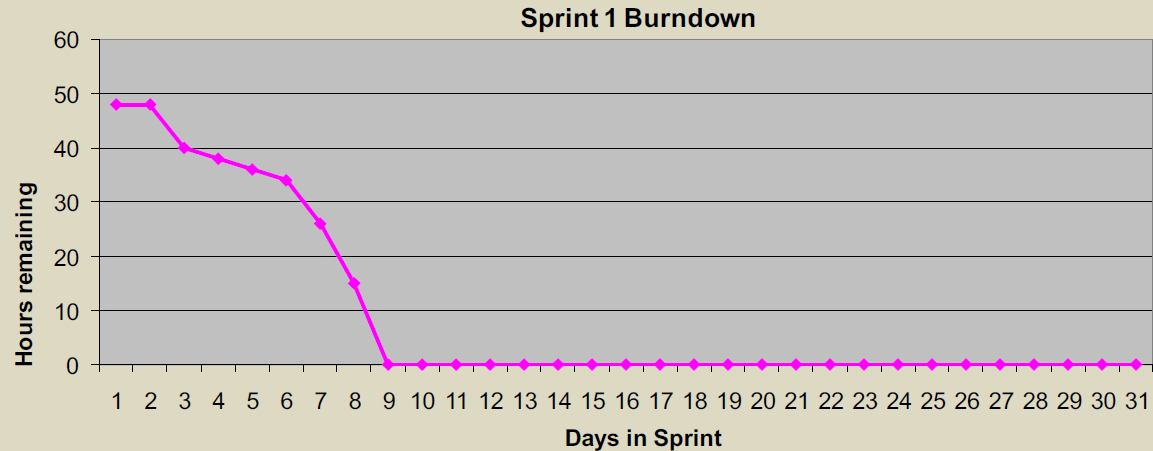

Alternatively, it can be too fast - which would look as follows:

Burn Down Fast

Possible Problems

Specialized Job Roles
